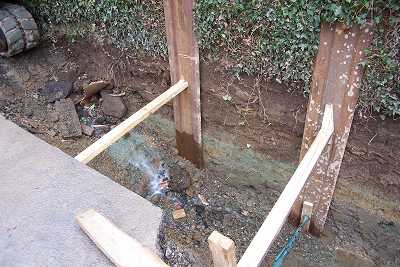

The western stream is flowing from the old broken pipe just in front of the digger track. The far trench side is tight against the base of the wall. The subsoil layers are a bit on the soft side and are shored up to avoid risk of collapse.
11/2/06

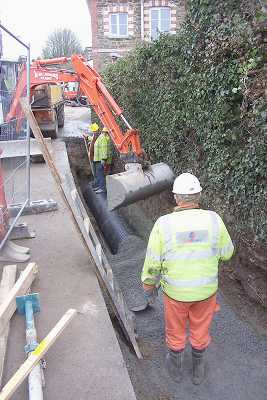

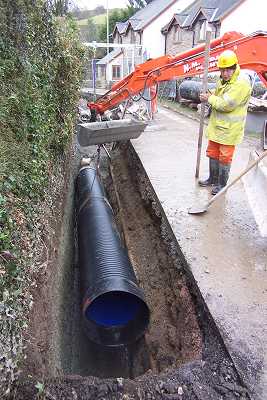

Another 6m length of 600ml twin-wall pipe is lowered into position. Good progress today - two lengths are excavated and laid.
13/2/06
The pipe has to be carefully embedded in concrete to stop it 'floating' The two men standing on the far end are weighting it down and positioning it while the concrete is filled.
13/2/06

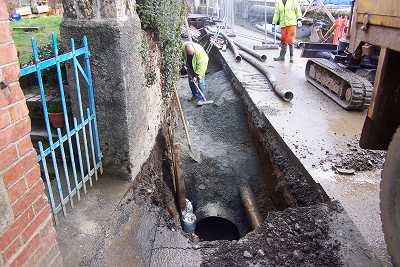

Outside 5 St Andrew's Cottages they're soon going to need a bridge. The main sewer can be seen running alongside the twin-wall. The infill used for the original sewer trench is collapsing into the new trench and so the side around and above the sewer is being packed with concrete for strength and support.
14/2/06
